Tethered Power for Lightweight eVTOL Flight Testing

High-voltage ground power + lightweight tether + onboard DC/DC conversion for longer, repeatable hover and propulsion-system validation.

Contact Sales
Lightweight eVTOL aircraft in a factory for tethered hover and propulsion testing.

Quick answer: A tethered eVTOL test setup moves the main energy source to the ground. High-voltage DC travels through a lighter tether, while an onboard converter regulates the voltage required by the aircraft bus. This can extend powered test windows from battery-limited minutes to multi-hour engineering sessions, subject to the aircraft and test-safety plan.

Lightweight eVTOL aircraft in a factory for tethered hover and propulsion testing.

Lightweight eVTOL platform in a manufacturing / R&D environment.

Why eVTOL R&D Teams Use Tethered Power During Early Testing

Early eVTOL development often requires repeating the same hover, propulsion and control experiments many times. Battery-only test windows can make long-duration motor runs, thermal stabilization, vibration observation and redundancy testing harder to schedule because the test must stop when the battery reaches its operating limit.

A tethered power architecture changes that constraint. The ground unit provides the bulk energy, the tether transmits it at high voltage to reduce cable current, and the onboard converter supplies the aircraft at its required DC bus voltage. The aircraft can then be tested for longer periods without treating battery energy capacity as the primary duration limit.

eVTOL aircraft research and development platforms for tethered hover testing.

Multiple lightweight eVTOL platforms in an R&D / production setting.

Test Activities That Benefit from Longer Powered Windows

  • Motor endurance and sustained-output testing

  • Thrust stability and propulsion efficiency mapping

  • Flight-control tuning and repeatable hover experiments

  • Redundant propulsion switching tests

  • Vibration and acoustic observation over longer thermal cycles

  • Emergency-condition and fault-response simulation within a controlled test plan

  • Powertrain and DC-bus validation before broader free-flight campaigns

Reference Architecture

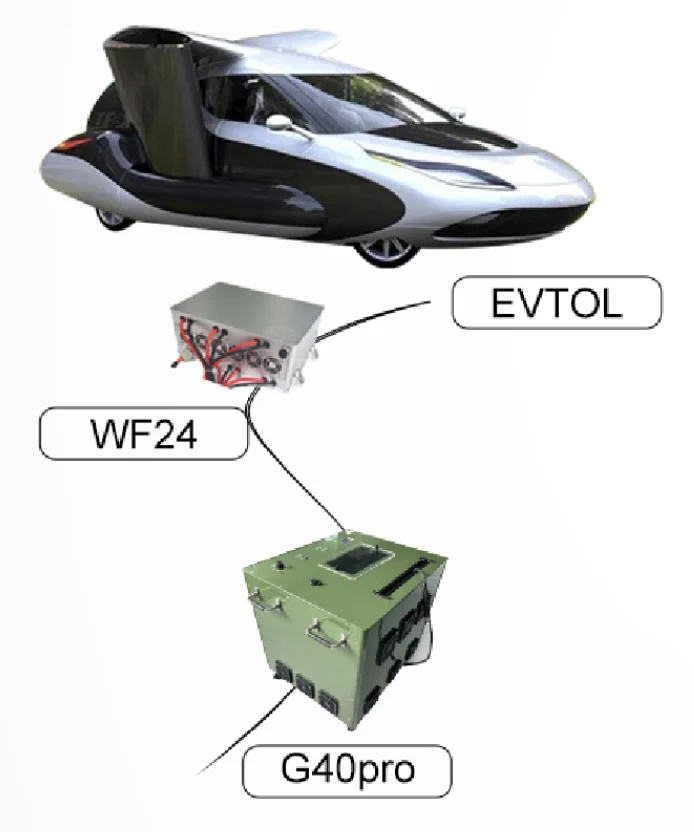

Tethered power architecture for eVTOL testing with ground power and an airborne DC DC module.

Reference architecture: ground high-voltage source, tether, WF24 airborne conversion and eVTOL DC bus.

StageFunctionConfiguration reference values
Ground inputReceives facility power and converts it to high-voltage DC380 V AC, 3-phase
Ground power unitHigh-voltage DC transmission sourceG40Pro; 1,000 V DC output; up to 30 kW peak in this configuration
TetherCarries HVDC from ground to aircraftHigh-strength high-voltage cable; exact length/conductor selected to the project
Airborne converterSteps tether voltage down to aircraft busWF24; 800-1,000 V DC input; 60 V / 14S reference output; up to 24 kW peak
Aircraft busSupplies propulsion / test systemsReference project used a 14S / 60 V class secondary bus

G40Pro high-voltage ground power station for tethered eVTOL hover testing.

Reference G40Pro-class ground high-voltage power unit.

WF24 airborne DC DC power module for tethered eVTOL flight testing.

Reference WF24-class onboard DC/DC power module.

Reference Overseas eVTOL Project Logic

This overseas lightweight eVTOL test project uses a 1,000 V DC tethered transmission stage and an onboard regulated 14S / approximately 60 V aircraft bus. The purpose was not to make the aircraft permanently tethered; it was to create a repeatable engineering power source for hover, propulsion and control tests before later free-flight development.

Safety and Test-Envelope Considerations

  • Power tether vs. mechanical restraint - a power cable should not automatically be treated as a certified arresting tether. If physical flight-envelope restraint is required, it should be engineered separately for the expected loads and failure cases.

  • Emergency battery / backup logic - define what happens if ground power, tether voltage or onboard conversion is interrupted.

  • Cable force and aircraft dynamics - tether weight, drag and payout force can affect hover behavior and flight-control tuning.

  • Thermal management - long test runs expose motors, ESCs, converters and connectors to thermal conditions that short battery flights may not reveal.

  • Ground electrical safety - high-voltage DC architecture requires appropriate interlocks, grounding, insulation, emergency stop and operating procedures.

  • Authorization - a constrained tethered test may simplify some site risk controls, but regulatory approval is jurisdiction- and test-specific and should never be assumed.

What we need to size an eVTOL test system

Input from the R&D teamWhy it matters
Aircraft DC bus voltageSets the required regulated airborne output.
Continuous hover powerDefines the normal thermal and electrical load.
Peak / transient powerDetermines converter and ground-source margin.
MTOW and spare payloadLimits airborne converter and tether mass.
Target hover height / test radiusDrives cable length, drag and mechanical layout.
Test altitude and ambient temperatureAffects cooling and derating.
Ground power availableDetermines whether facility AC, generator or another source is appropriate.
Backup strategyDefines battery interface, transfer logic and emergency behavior.

Frequently Asked Questions

What is the main benefit of tethered power in eVTOL testing?

It decouples many hover and propulsion tests from onboard battery energy capacity, allowing longer and more repeatable powered test windows.

Does the tethered setup replace batteries completely?

Not necessarily. A development team may retain a battery for transient support, emergency backup or later free-flight phases. The exact architecture depends on the aircraft power bus and safety strategy.

Can the system be used for propulsion tests without free flight?

Yes. Ground/high-voltage and onboard conversion can support controlled hover or other test-rig configurations where continuous aircraft-bus power is useful.

Does tethering automatically make urban or restricted-area testing legal?

No. Tethering can constrain the operating area, but site permission and aviation requirements remain jurisdiction-specific.

What should be provided for initial selection?

Bus voltage, continuous/peak power, MTOW, spare payload, target height, ambient conditions, ground source and backup strategy.
